Green Section Phasing/Sequencing Maps
Allied plans to address the streets in the Green section in three phases — Phases 1, 2, and 3; within each phase, construction crews will work on the east or north side of the street first (Phases 1A, 2A and 3A), then the west or south side (Phases 1B, 2B, and 3B).
Streets in each phase:
Phase 1 — Amberly, Endsleigh, Covington Place, and Glengarry.
Phase 1A will address the north sides of Amberly/Endsleigh/Covington Place, and the east side of Glengarry. Crews will start at Glengarry Circle, move south on Glengarry and turn onto Amberly. Once the north side of Amberly is completed, crews will start on the east side of Glengarry at Amberly, moving south and turning onto Endsleigh. Then the crew will address the north side Covington Place, starting at Endsleigh and moving east to Covington. Lastly, crews with complete the last short piece of Glengarry, moving from Endsleigh south to Bradway.
Phase 1B will address the south sides of Amberly/Endsleigh/Covington Place, starting on each street at Glengarry and moving east to Covington Road. Work on the west side of Glengarry will move from the Circle south to Bradway.
Phase 2 - Tuckahoe, Sunnydale, Hupp Cross, Morningview, Drury, Overhill (in that order)
Phase 2A will address the east sides of Tuckahoe/Hupp Cross/Drury/Overhill and the north sides of Sunnydale/Morningview.
Phase 2 B will address the west sides of Tuckahoe/Hupp Cross/Drury/Overhill and the south sides of Sunnydale/Morningview.
Phase 3 — Bradway Blvd.
Allied has not yet shared with us how they plan to address Bradway.
The maps below show the order for Phases 1 (outlined in red) and 2 (outlined in green). The yellow lines on each map show the side of each street that will go first.

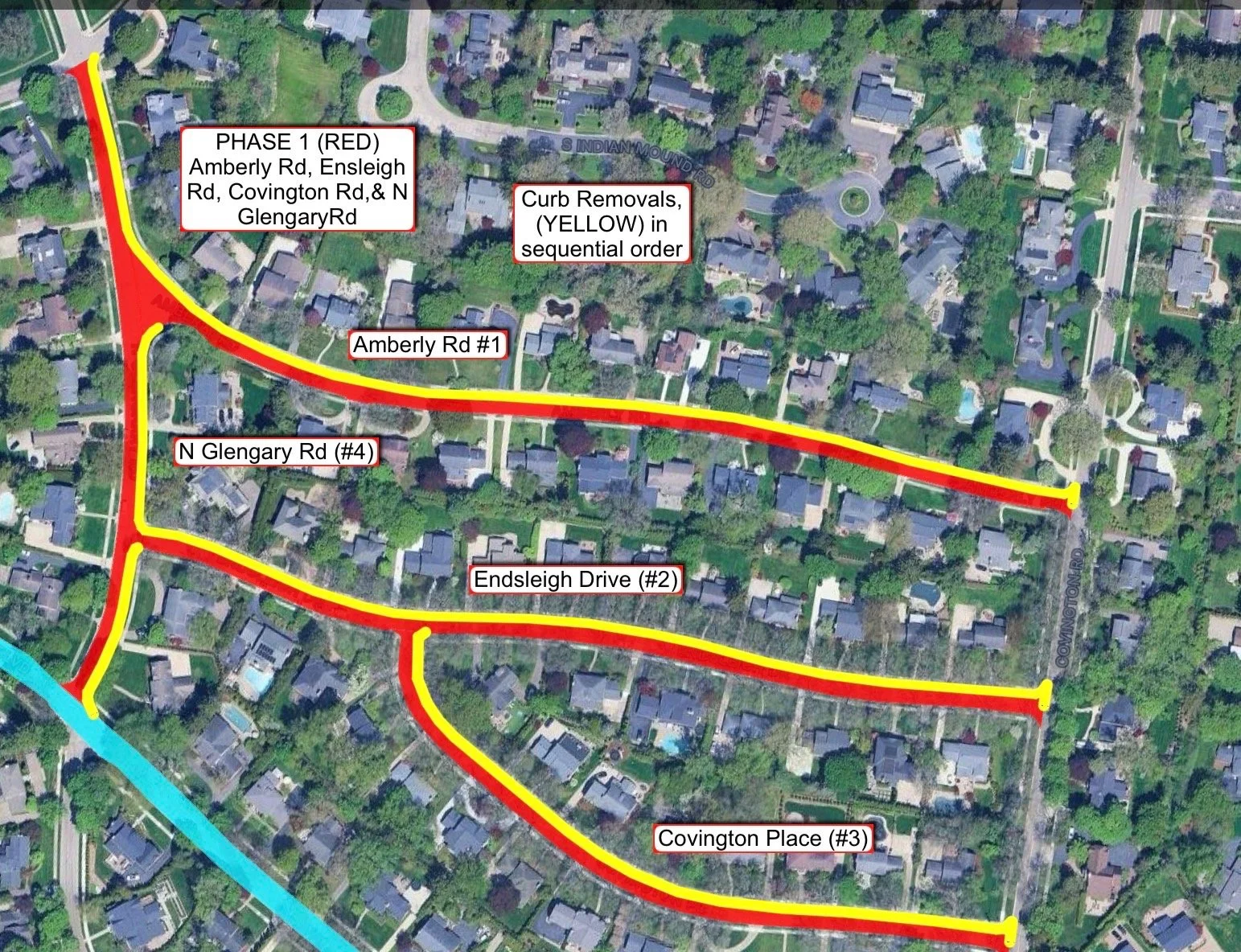

Phase 1 Map

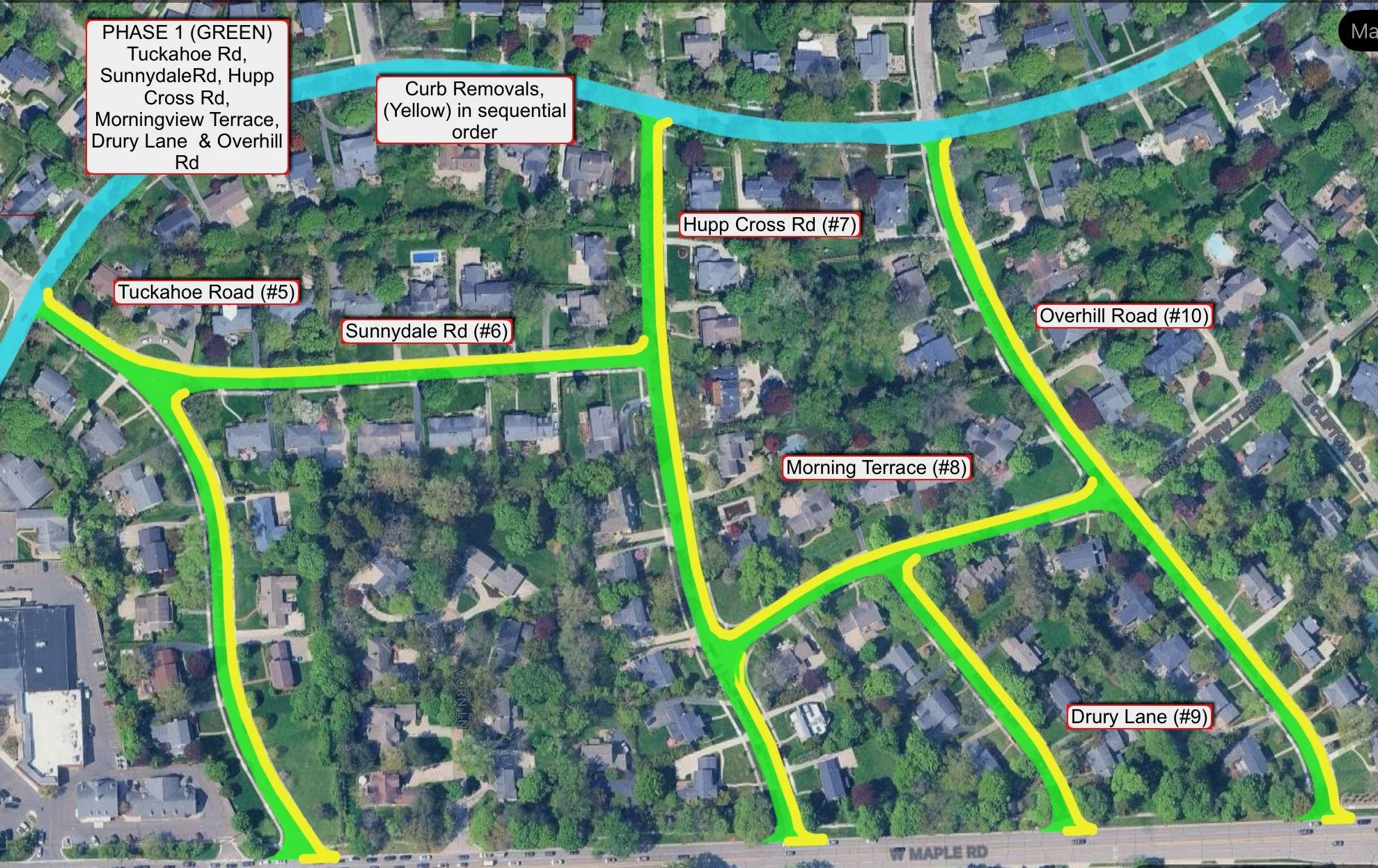

Phase 2 map
